Ringlock scaffolding support system erected for bridge construction
Ringlock Scaffolding Blog

How to Erect Ringlock Scaffolding: A Practical Step-by-Step Guide

31 8 月, 2026 admin1

A practical Ringlock scaffolding erection guide covering layout, the first bay, standards, ledgers, bracing, alignment and U-head setup.

 Ringlock scaffolding shoring system during erection on a construction site

To erect Ringlock scaffolding: lay out the grid, position the base jacks and base collars, install the first ledgers and square the starting bay, then add standards, ledgers and diagonal braces progressively while checking alignment at each lift. Install U-head jacks where required at the top and inspect the complete scaffold before loading.

The first bay usually decides how smoothly the rest of a Ringlock scaffold goes together.

If the starting grid is already out of level or square, adding more standards and ledgers rarely fixes it. The error normally follows the scaffold upward, and the crew ends up compensating for it at every new lift.

The erection sequence itself is straightforward: set out the grid, position the adjustable bases and base collars, connect the first ledgers, square the starting bay, add standards and bracing, then continue upward while checking alignment.

The important part is knowing what should be checked before moving on.

Table of Contents
  1. Ringlock Erection Sequence
  2. Set Out the Grid
  3. Position Base Jacks and Base Collars
  4. Build the First Bay
  5. Install Standards and Ledgers
  6. Install Diagonal Braces
  7. Continue Upward and Check Alignment
  8. Install U-Head Jacks
  9. Check the Scaffold Before Loading
  10. Correct Problems Where They Start
  11. Frequently Asked Questions

Ringlock Erection Sequence

A typical sequence is:

  1. Set out the scaffold grid
  2. Position adjustable base jacks and base collars
  3. Connect the first ledgers
  4. Level and square the starting bay
  5. Install standards
  6. Add the next level of ledgers
  7. Install diagonal braces
  8. Continue standards, ledgers and bracing upward
  9. Install U-head jacks where required
  10. Complete the pre-use inspection

The exact arrangement depends on the scaffold design and application, but alignment and bracing should be checked as the scaffold rises rather than left until the end.

1. Set Out the Grid Before You Start Building

Start from the approved scaffold layout.

Mark the positions of the standards and confirm the intended bay lengths, transverse spacing and any changes around walls, columns, beams or openings.

Do not casually move a standard because an obstruction makes the original position inconvenient. A change in one bay can affect brace geometry, beam support positions and the load path through the scaffold.

The ground or supporting surface should also be checked before erection begins. Base jacks need firm, stable support. Loose bricks, reinforcing-bar offcuts or other improvised packing are not a proper way to correct an uneven foundation.

2. Position the Base Jacks and Base Collars

Place the adjustable base jacks at the marked positions and fit the base collars.

Use the base jack for fine leveling, not to compensate for a badly prepared foundation or the wrong scaffold height.

Before moving on, check that every base is properly supported and that enough screw remains engaged inside the receiving tube.

On some Chinese Ringlock support-scaffold projects, exposed base-jack screw length is commonly controlled at around 300 mm, with at least 150 mm engaged inside the standard. These figures should be treated as project or jurisdiction-specific references, not universal limits.

If unusually large adjustment is needed at the first level, check the foundation elevation and scaffold configuration before simply extending the screw farther.

3. Build the First Bay Carefully

Connect the first ledgers between the base collars to form the starting grid.

This first bay becomes the reference for everything that follows.

Check:

  • bay dimensions
  • ledger level
  • standard positions
  • diagonal dimensions of the bay
  • support under every base

If the bay is visibly out of square, correct it now.

Do not continue for several bays and hope the system will gradually pull itself back into line. Ringlock is modular, and positioning errors repeat just as easily as the correct dimensions do.

A few minutes spent on the starting bay can save much more time higher up.

Site CheckIf the next level begins to require unusual force during assembly, do not assume the upper components are the problem. Recheck the starting bay, ledger level and standard seating first. Small errors near the bottom can become much more obvious several lifts higher.

4. Install Standards and the Next Level of Ledgers

Once the starting grid is level and square, install the Ringlock Standards and connect the next level of Ringlock Ledgers.

Check that each standard is seated correctly and remains reasonably plumb as the frame develops.

Ledger heads should sit properly against the rosette before the wedge is driven home.

A wedge passing through the rosette does not automatically mean the joint is correctly locked.

If a connection still feels loose after normal installation, do not solve the problem by simply hitting the wedge harder. The ledger head, wedge, rosette and connection area should be inspected.

Site CheckA wedge passing through the rosette is only one part of the connection check. The ledger head should also sit normally against the rosette and the joint should not remain abnormally loose. If it does, inspect the connection rather than simply striking the wedge harder.

Detailed Ringlock connection inspection will be covered separately in this technical series.

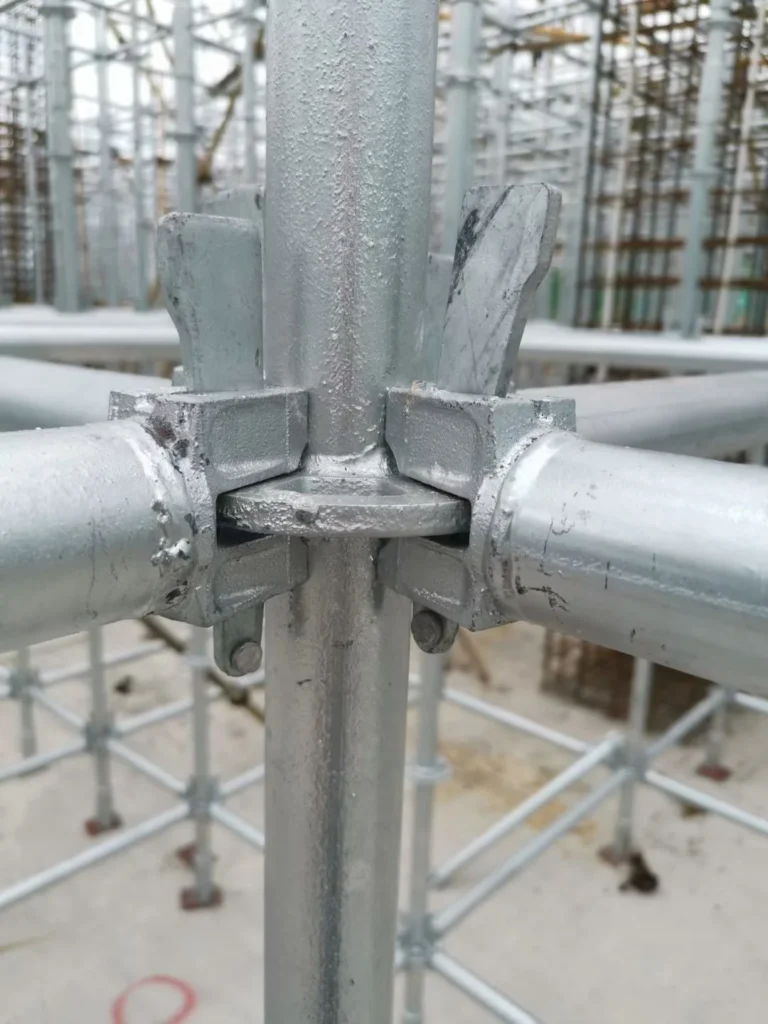

Ringlock ledger heads and wedges connected to a rosette



5. Install Diagonal Braces as the Scaffold Rises

Diagonal braces should not be treated as finishing pieces.

Install the required bracing progressively as the scaffold is erected.

A partially erected frame may appear stable while unloaded, but that does not mean the designed lateral-restraint system can be postponed until the final height is reached.

Bracing also helps control the geometry of the scaffold while erection continues.

The exact brace arrangement depends on the scaffold height, load, application and approved design. A high or heavily loaded support scaffold should not simply copy the brace arrangement used on a low, lightly loaded frame.

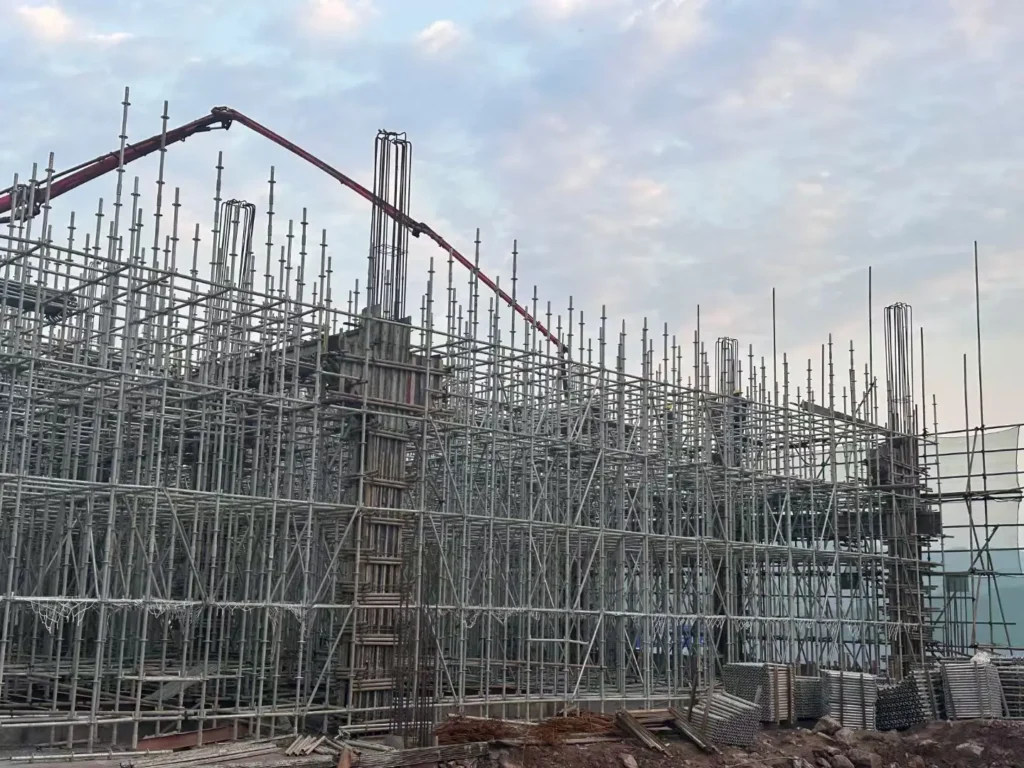

Ringlock scaffolding support structure with diagonal bracing during erection

6. Continue Upward, but Keep Checking Alignment

Continue the normal sequence:

standard → ledger → alignment check → bracing → next lift

Do not separate erection and inspection into two completely different jobs.

Watch for signs that something lower in the scaffold has started to drift:

  • ledgers no longer appear level
  • upper components require unusual force to connect
  • standards begin leaning in the same direction
  • braces become difficult to install
  • the scaffold no longer follows the marked grid

When this happens, look for the level where the error started.

Trying to force the top of the scaffold back into position can create a second problem without correcting the first one.

7. Install U-Head Jacks Correctly

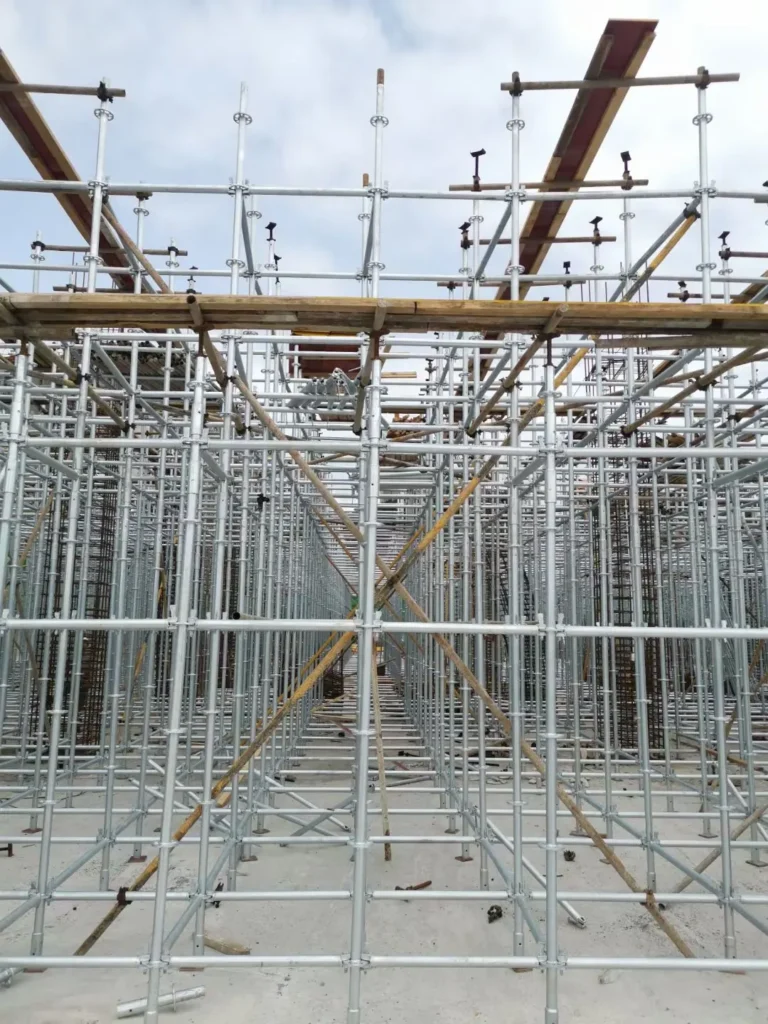

For shoring applications, adjustable U-head jacks are normally used at the top of the Ringlock frame to support the primary beam system.

They should be used for final level adjustment, not to make up for a scaffold that was erected to the wrong height.

Keep the supported beam reasonably centred in the U-head so that the load enters the jack and standard as directly as possible.

Some Chinese support-scaffold requirements use reference limits for U-head screw exposure, engagement length and cantilever distance. These values vary by project and jurisdiction, so the approved design and applicable local standard should always take priority.

Site CheckIf a U-head needs unusually large adjustment to reach the required elevation, check the scaffold height and the setup below it before extending the jack further. Final adjustment should not become a substitute for correcting an earlier erection error.

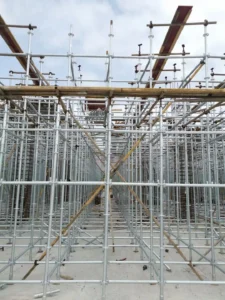

Ringlock shoring system with adjustable U-head jacks supporting the upper beam layout

8. Check the Scaffold Before Loading

Before the scaffold is loaded, inspect the completed structure.

At minimum, check:

Check Point What to Look For
Base support Stable bearing with no visible gaps, movement or unsupported base plates
Scaffold grid Bay positions and dimensions remain consistent with the approved layout
Standard verticality No obvious leaning; verify against the project acceptance tolerance
Ledger level No obvious sagging, high points or abnormal misalignment
Wedge engagement Connections are properly seated and do not remain abnormally loose
Diagonal bracing Required braces are installed in the positions specified by the design
Standard joints Vertical connections are fully seated without obvious partial engagement
U-head position U-heads are properly adjusted and the supported beam is reasonably centred
Visible damage No obvious cracks, severe bending, damaged connections or serious corrosion
Additional stability measures Ties, restraints or other measures required by the approved design are in place

This is a pre-use erection check rather than a complete component inspection procedure. Detailed inspection criteria for individual Ringlock components are covered separately in the technical series.

Correct installation is not just about having the right components. The geometry and connections of the assembled scaffold matter just as much.

Correct Problems Where They Start

A useful site rule is simple:

If the scaffold starts going out of level, square or plumb, find where the error began.

The same principle applies to connections.

If a wedge does not lock normally, inspect the node.

If a brace does not fit normally, check the bay geometry before blaming the brace.

If a U-head needs extreme adjustment, check the scaffold height below it.

Good Ringlock erection is not about forcing modular parts together. It is about keeping the geometry, connections and load path under control from the first bay upward.

FAQ

Frequently Asked Questions

Quick answers to common Ringlock scaffolding erection questions.

What is the basic sequence for erecting Ringlock scaffolding?

Start with the approved grid, position the base jacks and base collars, build and square the first bay, install standards and ledgers, add diagonal braces as erection progresses, then continue upward and complete the final adjustment and inspection.

When should diagonal braces be installed?

Required diagonal bracing should normally be installed progressively as the scaffold rises rather than waiting until the full height has been erected.

Can adjustable jacks correct a badly leveled scaffold?

Adjustable jacks are intended for controlled final adjustment. Large differences in elevation should be corrected through the foundation, scaffold arrangement or approved design rather than excessive screw extension.
